Mobilization
Stated separately, and stated again for each return visit if the work is phased across years. It does not scale down with the section.
Community dredging fails on governance more often than on engineering: a scope nobody can compare bids against, a spend nobody can justify at the annual meeting, and a plan that evaporates when three directors rotate off.
A private owner decides and the work happens. A board has to decide, document, fund and defend — usually across more than one budget year and more than one set of directors.
So the deliverable a community needs is different from the one a homeowner needs. Not a price for a shoreline, but a scope station by station: a marked map, a condition note at each station, and a priority order that records why each section sits where it does. That is what lets a treasurer build a line item, a committee compare two contractors on the same terms, and next year's board understand a decision it was not in the room for.
It is also the honest answer to the question boards are most nervous about. When the reasoning is written down beside the priority, an owner asking "why is our stretch last?" gets an answer rather than a shrug.
Three ownership questions decide the shape of a community dredge, and all three are cheaper to answer before a contractor is engaged than after.
What is common area and what is a lot? Silt does not follow property lines, so the boundary between association work and member work has to be drawn on a map rather than argued case by case. What may the association spend on? That comes out of the governing documents, and it is a question for the association's own advisers, not for us. And who is the applicant? On the river-authority lakes the authorization attaches to the property interest and to the approved scope, so on common-area frontage it is normally the association that applies, not a member.
Getting those three settled in advance is what stops a well-intentioned program stalling halfway through its first budget year.
A POA canal system has a structural unfairness built into it that a board has to name out loud. Canals shoal hardest at the mouth, where the current from the open lake dies as it turns in. That mouth usually fronts one or two lots — and if it closes, every lot behind it loses access, whatever depth sits at their own bulkhead.
So the entrance is common infrastructure whatever the plat says about who owns the bed there, and it belongs at the top of the priority order for the same reason a marina's access channel does: there is no alternative route. Members further in with plenty of depth at their own dock sometimes need that explained, and it is much easier to explain from a marked map with soundings at each station than from a bid summary.
The mechanism behind the shoaling — why the mouth, and why it comes back — is on the dredging hub.
Ask every contractor for the same breakdown and the differences between them become visible in an afternoon.
Stated separately, and stated again for each return visit if the work is phased across years. It does not scale down with the section.

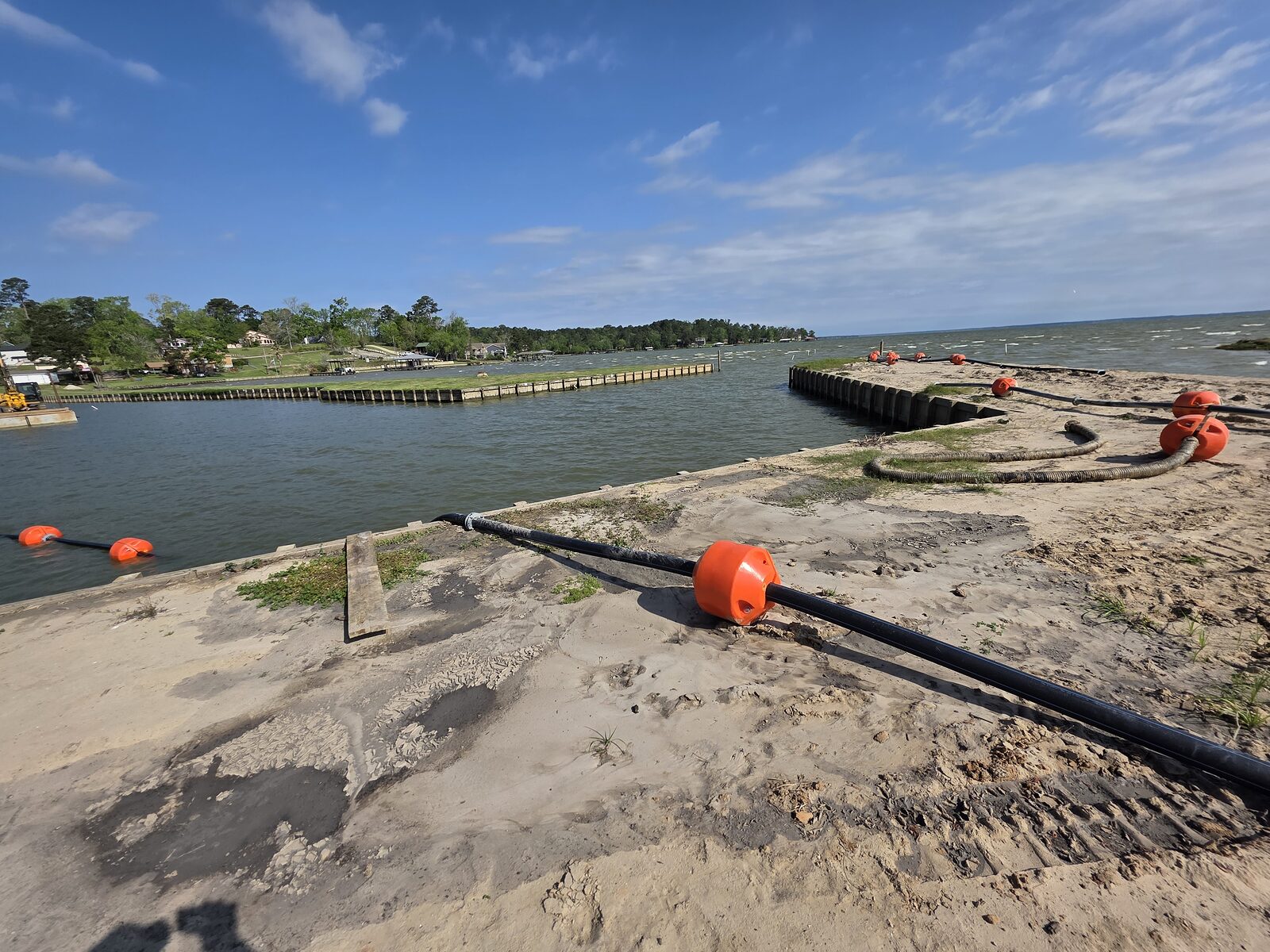

How the rig reaches the water, and how far material has to travel from each station to wherever it is allowed to rest.
Settling area, geotextile tube or press — and how much common-area ground each one needs while it is happening.
Named, not implied. This is the item most likely to differ between two bids and least likely to be spelled out in either.
Not a construction cost, but the item most likely to move a start date past your budget year.
What each priority section is expected to take out, so the board can cut scope by station instead of renegotiating everything.
Splitting a shoreline across budget years is normally the point of scoping it as a program. The stations that cannot wait get done first and the rest are phased into the years that can carry them — with the honest caveat that every separate return to the water carries its own mobilization, so five one-station years cost more in total than two larger phases. That is a trade for the board to make with the number in front of it.
Individual members frequently want their own frontage done while the equipment is there, which is much cheaper for them than a separate mobilization later. It has to run as separate work with its own authorization rather than folded into the common-area scope, so the association is not funding private frontage. What a member needs to know is on the boat slip page; if your community runs a basin or fuel dock, the sequencing argument is on the marina page.
Dave will join a board call or come to a meeting and walk through the map, the priority order and the sequencing directly, which is generally faster than three rounds of questions through a bid document.

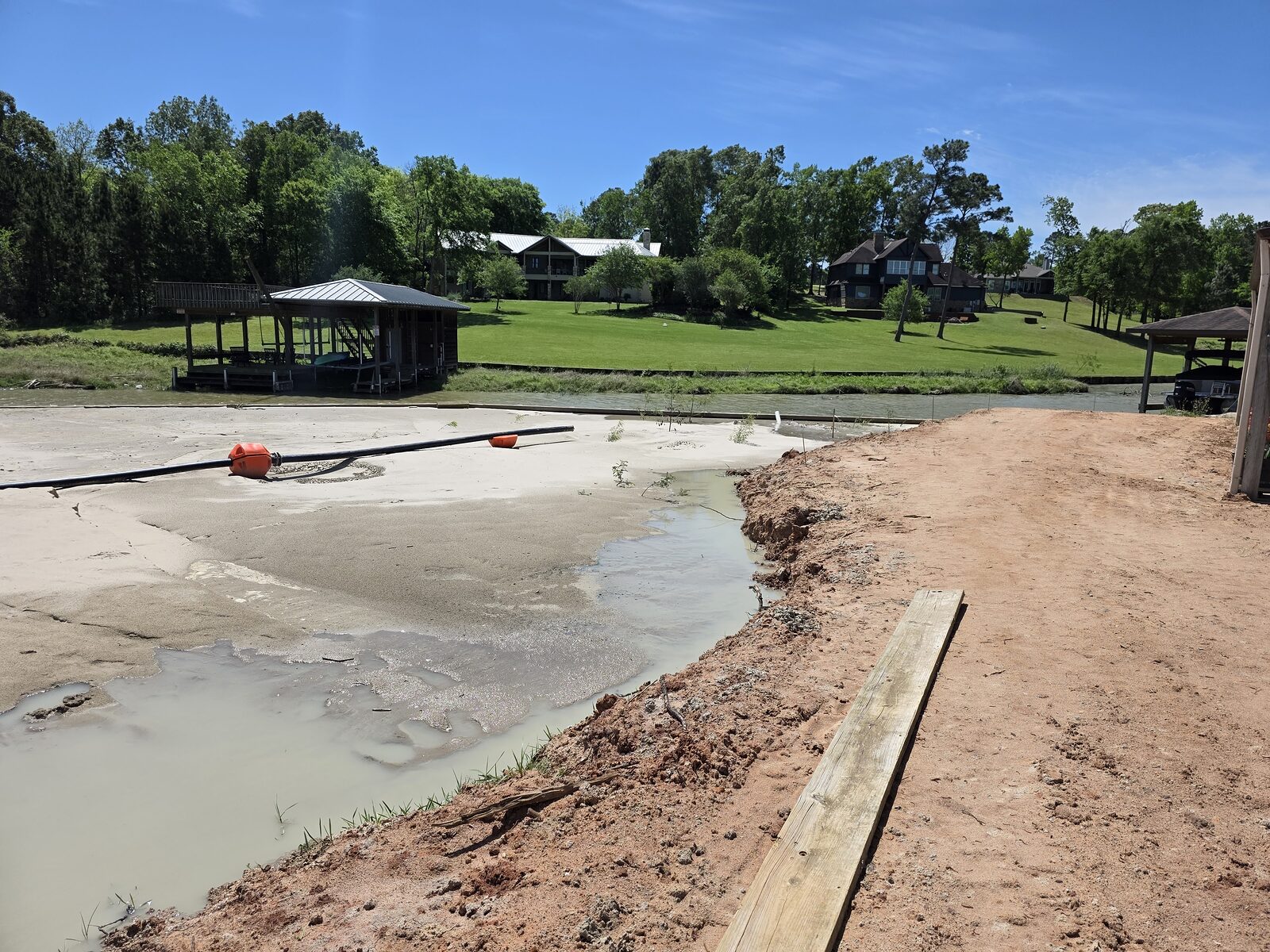

On common-area water the spoil question is the board's question. A settling pond on association land keeps the material on site and the trucks off the roads.
Whoever holds the property interest the authorization has to attach to, which on common-area frontage is normally the association rather than any individual member. It is worth settling that with your governing documents in hand before an application is filed, because the authorization attaches to the property and to the approved scope, and correcting the applicant afterwards is slower than getting it right.
Station by station, with the reasoning recorded rather than only the conclusion. A marked map, a condition note at each station, and a priority order that says why each section sits where it does. Boards turn over and institutional memory goes with them. A scope that carries its own reasoning survives that; a single number on a page does not.
That is usually the point of scoping it as a program rather than a job. The stations that cannot wait are identified first and the rest are phased so the spend lands where the budget can carry it. The trade to weigh is that each separate return to the water carries its own mobilization.
Frequently yes, and it is far cheaper for that member than bringing equipment out on its own. It has to be handled as separate work with its own authorization rather than folded into the common-area scope, so the association is not paying for private frontage and the paperwork stays clean.
Ask for the same line items from everyone: mobilization, access, how far material has to be conveyed, the dewatering method, the destination for the spoil, and the permitting time assumed. Two lump sums for a whole shoreline are not comparable, and a contractor willing to break those out is showing you a diagnosis rather than asserting one.
Send the plat or a marked aerial, any soundings the community has taken, and the date of your next meeting. Dave will walk the frontage and come back with stations, priorities and reasons.
